HomeGround ImprovementDiseño de precarga (sin sobrecarga)

Preloading Design (Without Surcharge) in Hobart – Ground Improvement for Soft Estuarine Soils

In Hobart, the widespread estuarine deposits of the Derwent River delta present a classic challenge for preloading design without surcharge. Under AS 4678:2002 for earth-retaining structures and AS 1726:2017 for geotechnical site investigations, we model consolidation rates using Terzaghi's one-dimensional theory with site-specific oedometer data. Hobart's typical soft clay profiles, with natural moisture contents exceeding 80% in some tidal flats, require careful staged loading to avoid bearing failure during fill placement. Our design integrates settlement plates and piezometer arrays to verify pore pressure dissipation in real time, ensuring that the target post-construction settlement — often limited to 25 mm for critical infrastructure — is achieved before pavement or foundation works commence.

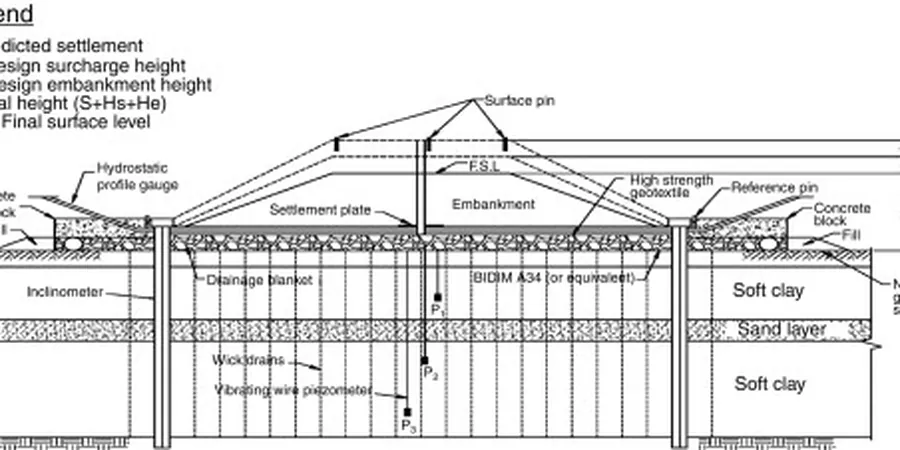

Illustrative image of Precarga in Hobart
For Hobart's estuarine clays, preloading without surcharge typically achieves 90% primary consolidation within 6 to 18 months, depending on cv and drainage path length.

Methodology and scope

Local experience in Hobart shows that preloading without surcharge demands a thorough understanding of the soil's coefficient of consolidation (cv), which can vary by an order of magnitude between the upper estuarine muds and deeper fluvial sands. We typically specify a fill height between 2.5 m and 4.5 m, depending on the required effective stress increment, and we maintain a factor of safety against undrained failure of at least 1.4 during construction. For projects near the waterfront, where groundwater is shallow and tidal fluctuations affect pore pressures, we complement the preloading design with vertical drains to accelerate consolidation when time constraints are tight. The design also accounts for secondary compression (creep) in the organic-rich layers that are common in Hobart's low-lying suburbs like Moonah and Glenorchy.

Local considerations

The primary risk in Hobart's preloading projects is underestimating the lateral displacement of soft ground beneath the fill, which can damage adjacent services or existing structures. We use inclinometer casings installed to depths of 15–20 m to monitor horizontal movements, and we limit the fill placement rate to 0.3 m per week in the most sensitive zones. Another common issue is the presence of thin sand lenses within the clay profile — these can act as preferential drainage paths but may also cause differential settlement if their thickness varies laterally. Our field testing program includes CPTu soundings to identify these lenses and to calibrate the consolidation model for the specific stratigraphy of each site in Hobart.

Need a geotechnical assessment?

Reply within 24h.

Email: contact@geotechnicalengineering1.vip

Applicable standards

AS 4678:2002 – Earth-retaining structures, AS 1726:2017 – Geotechnical site investigations, AS/NZS 1170.0:2002 – Structural design actions, general principles

Associated technical services

01

Site Investigation & Parameter Derivation

Boreholes with undisturbed sampling, oedometer testing, and CPTu soundings to determine cv, mv, and preconsolidation pressure for the estuarine clay profile.

02

Staged Fill Design & Monitoring Plan

Detailed fill sequencing with settlement plates, pneumatic piezometers, and inclinometers to verify consolidation progress and maintain stability.

03

Consolidation Modeling & Settlement Prediction

Finite-difference or analytical Terzaghi models calibrated to Hobart's specific soil data, with predictions for both primary and secondary compression.

04

Verification Testing & Load Removal Criteria

Post-consolidation CPTu and vane shear tests to confirm strength gain, plus a formal report certifying that target settlements have been achieved.

Typical parameters

ParameterTypical value
Coefficient of consolidation (cv)0.5 – 4.0 m²/year (vertical)
Preloading fill height2.5 – 4.5 m (without surcharge)
Target post-construction settlement≤ 25 mm for critical structures
Factor of safety against bearing failure≥ 1.4 (undrained)
Monitored pore pressure dissipation≥ 90% before load removal
Typical consolidation period6 – 18 months (Hobart estuarine clays)

Frequently asked questions

How long does preloading without surcharge typically take in Hobart?

For the estuarine clays of the Derwent delta, with a cv of 1–3 m²/year and a 4 m drainage path, 90% primary consolidation is usually reached within 10–14 months. Sites with sand lenses or higher cv can be faster, while deeper clay layers may extend the period.

Can preloading without surcharge handle differential settlement in variable fill?

Yes, but careful staging is required. Our design uses multiple settlement plates across the site to detect differential movement early. If lateral variability is high, we recommend combining preloading with vertical drains to equalize pore pressures more uniformly.

What happens if pore pressures don't dissipate on schedule?

We maintain a contingency in the fill placement schedule. If piezometers show slower-than-expected dissipation, we extend the wait period or add lightweight fill to reduce the load increment. In extreme cases, we switch to a surcharge design, but this is rare in Hobart's geology.

What is the typical cost range for a preloading design study in Hobart?

A comprehensive preloading design including site investigation, instrumentation, and monitoring typically ranges from AU$1,000 to AU$3,630, depending on site area, number of boreholes, and monitoring duration. Final cost is confirmed after the initial field program.
